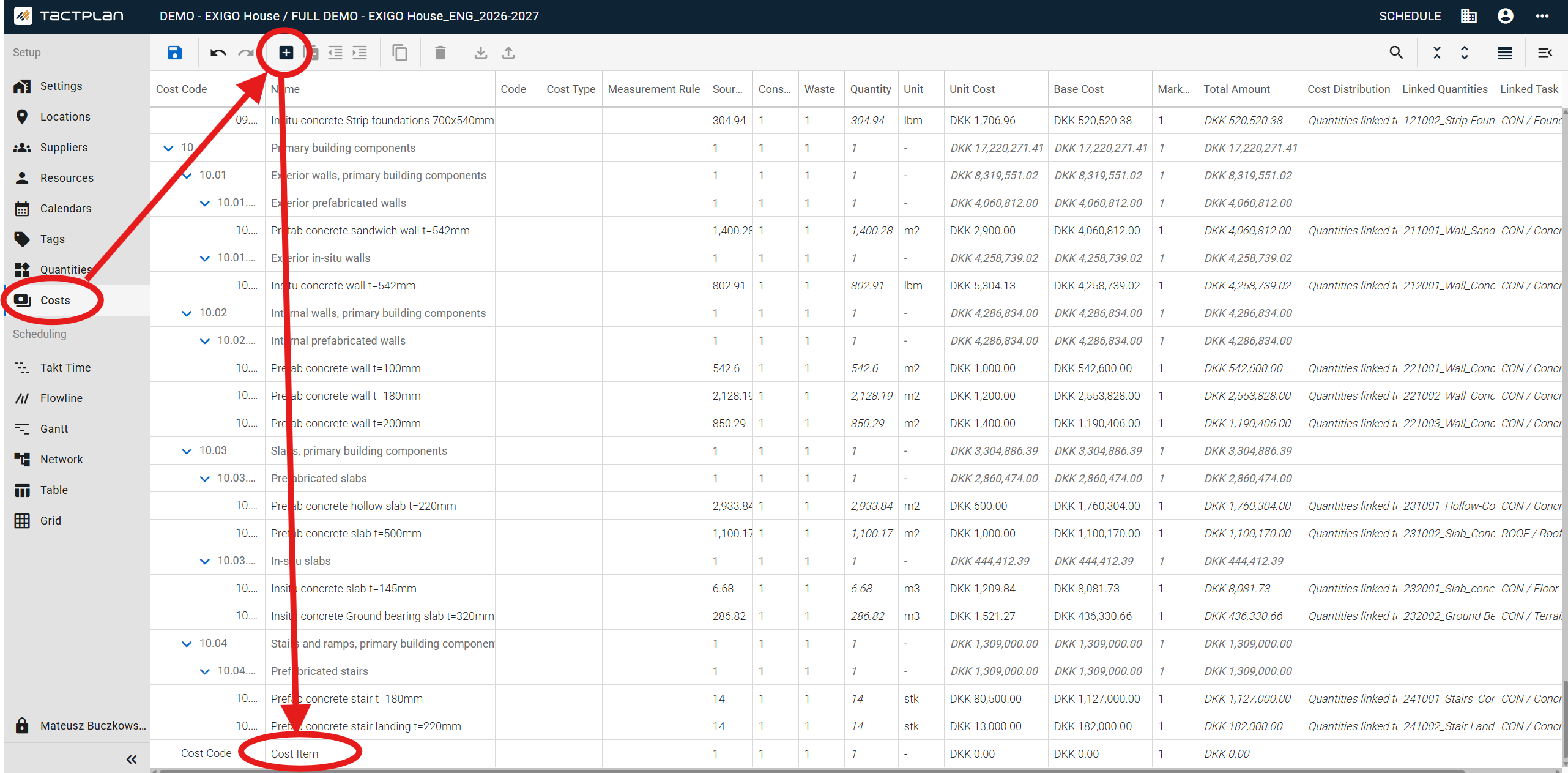

How to Add a Cost Item
- Navigate to Setup > Costs in the side navigation.
- Click the Add cost item button (+) in the toolbar. A new row appears at the bottom of the grid with the following default values:
- Cost Code: "Cost Code"
- Name: "Cost Item"
- Source Quantity: 1
- Consumption Factor: 1
- Waste: 1
- Quantity: 1
- Unit Cost: 0
- Markup Factor: 1
- Double-click any cell in the new row to edit its values.

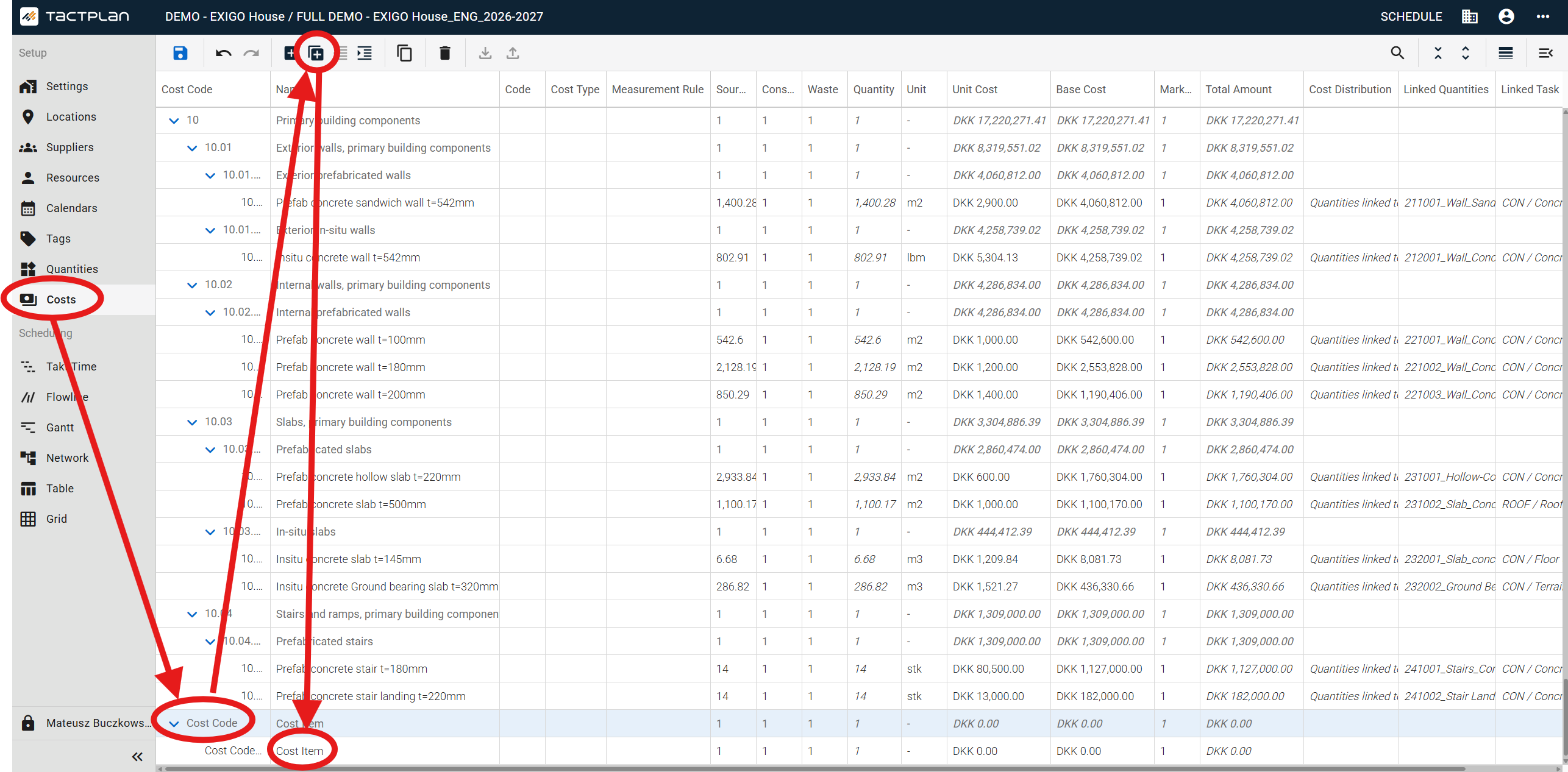

How to Add a Cost Sub-Item
- Select an existing cost item in the grid.
- Click the Add cost sub-item button in the toolbar. A new sub-item row appears below the selected cost item.
- The sub-item inherits a Cost Code based on the parent (e.g., "<parent cost code> New") and defaults to the same values as a regular cost item.
- Double-click any cell to edit its values.
Editing Cost Items
How to Edit Text Fields
The following fields are editable by double-clicking the cell: Cost Code, Name, Code, Cost Type, Measurement Rule, and Unit.
- Double-click the cell you want to edit. The cell becomes editable.
- Type the new value. Fields accept any string up to 255 characters. Empty values are allowed.
- Press Enter or click outside the cell to confirm.
Note: Entering more than 255 characters will trigger an "Invalid field value" validation message.
How to Edit Cost Values on a Sub-Item (Child)
The following fields are directly editable on sub-items (child cost items):
- Double-click Source Quantity, Consumption Factor, or Waste to edit. Accepted range: 0.00001 – 1,000,000,000,000.
- Quantity is calculated automatically: Source Quantity × Consumption Factor × Waste = Quantity. This field is not directly editable.
- Double-click Unit Cost to edit. Base Cost updates automatically: Quantity × Unit Cost = Base Cost.
- Double-click Base Cost to edit. Unit Cost updates automatically.
- Double-click Markup Factor to edit. Total Amount updates automatically: Base Cost × Markup Factor = Total Amount.
- Total Amount is not directly editable — it is always calculated.
How to Edit Cost Values on a Parent Item
Unit Cost, Base Cost, Markup Factor, and Total Amount on a parent item are not directly editable when the item has sub-items — they are rolled up automatically from the sub-items.
- Double-click Source Quantity, Consumption Factor, or Waste on the parent to edit them directly.
- To update Unit Cost, Base Cost, Markup Factor, or Total Amount on the parent, edit the corresponding values on any of its sub-items — the parent values will update automatically.
Organizing Cost Items
How to Indent or Outdent a Cost Item
- Select a single cost item in the grid.

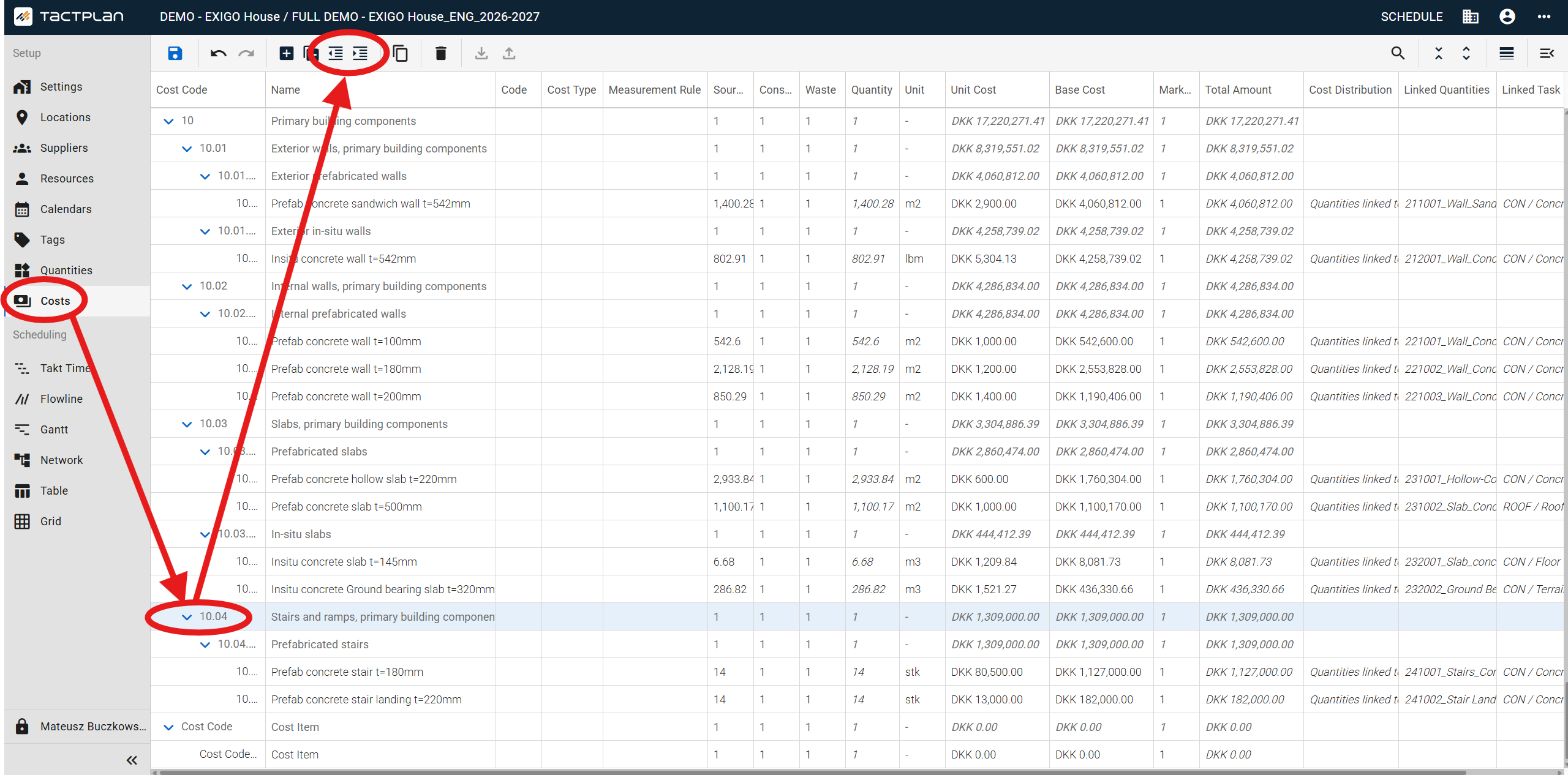

- To make it a sub-item of the item above it, click Indent in the toolbar. The item (and any of its sub-items) moves one level down.
- To promote it to the level of its parent, click Outdent in the toolbar. The item (and any of its sub-items) moves one level up and becomes a sibling of its former parent.
Note: Indent is only available when a sibling item exists above the selected item. Outdent is only available when the selected item has a parent. Both buttons are disabled when multiple items are selected.
How to Move a Cost Item
- Select one or more cost items in the grid.
- Drag and drop the selected items to a new position — either to a different level or a different position on the same level.
- Note that moving a cost item into one of its own descendants is not allowed and will be ignored.
How to Copy a Cost Item
- Select one or more cost items you want to copy (including items with sub-items).
- Click the Copy cost item button in the toolbar.
- A copy of the selected items (including sub-items) is placed at the bottom of the grid. Linked tasks are not carried over to the copy.

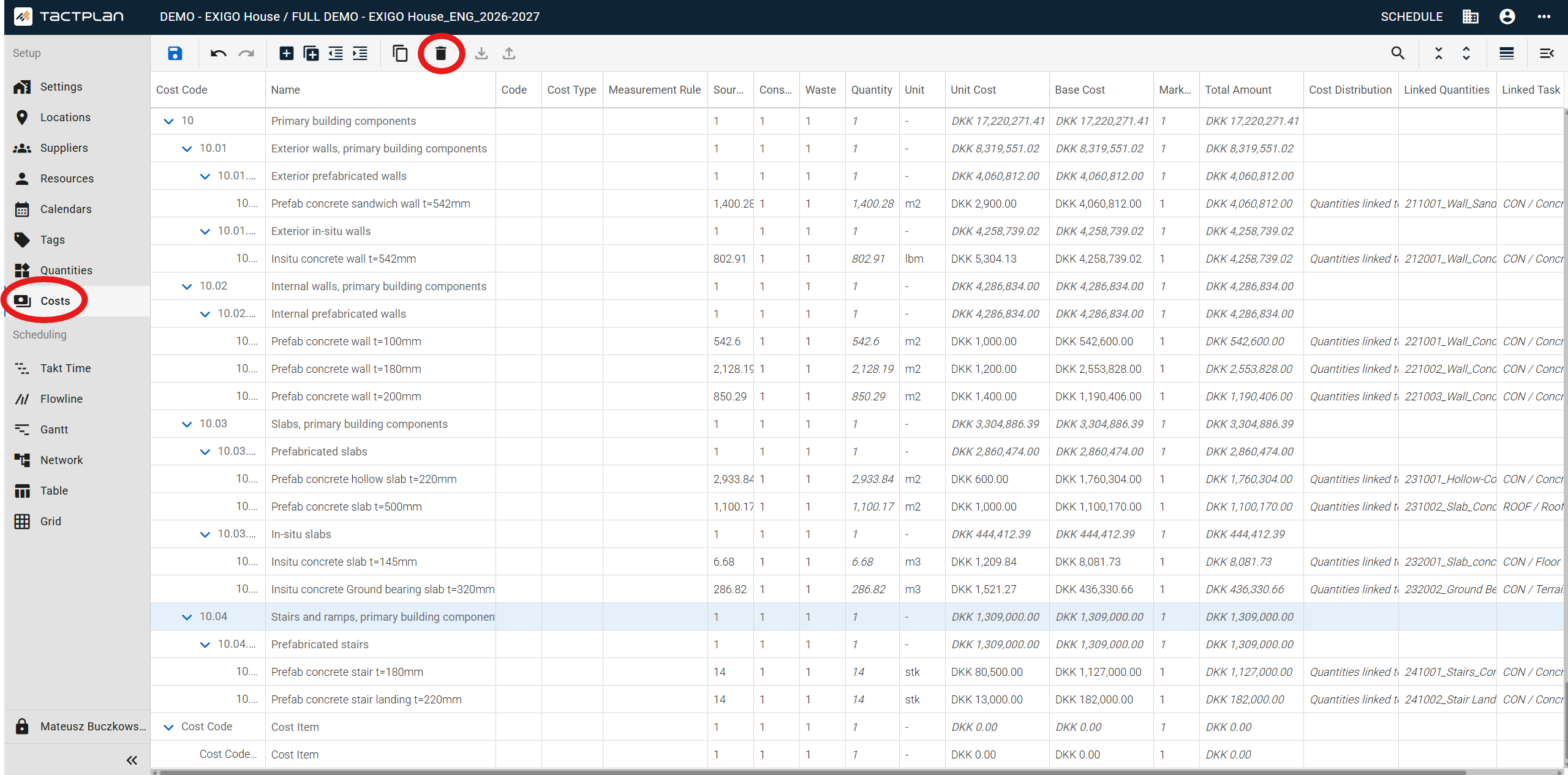

How to Delete a Cost Item
- Select one or more cost items you want to delete.
- Click the Delete button (trash icon) in the toolbar.
- A confirmation dialog lists the items selected for deletion. Click Delete to confirm.
Linking Cost Items

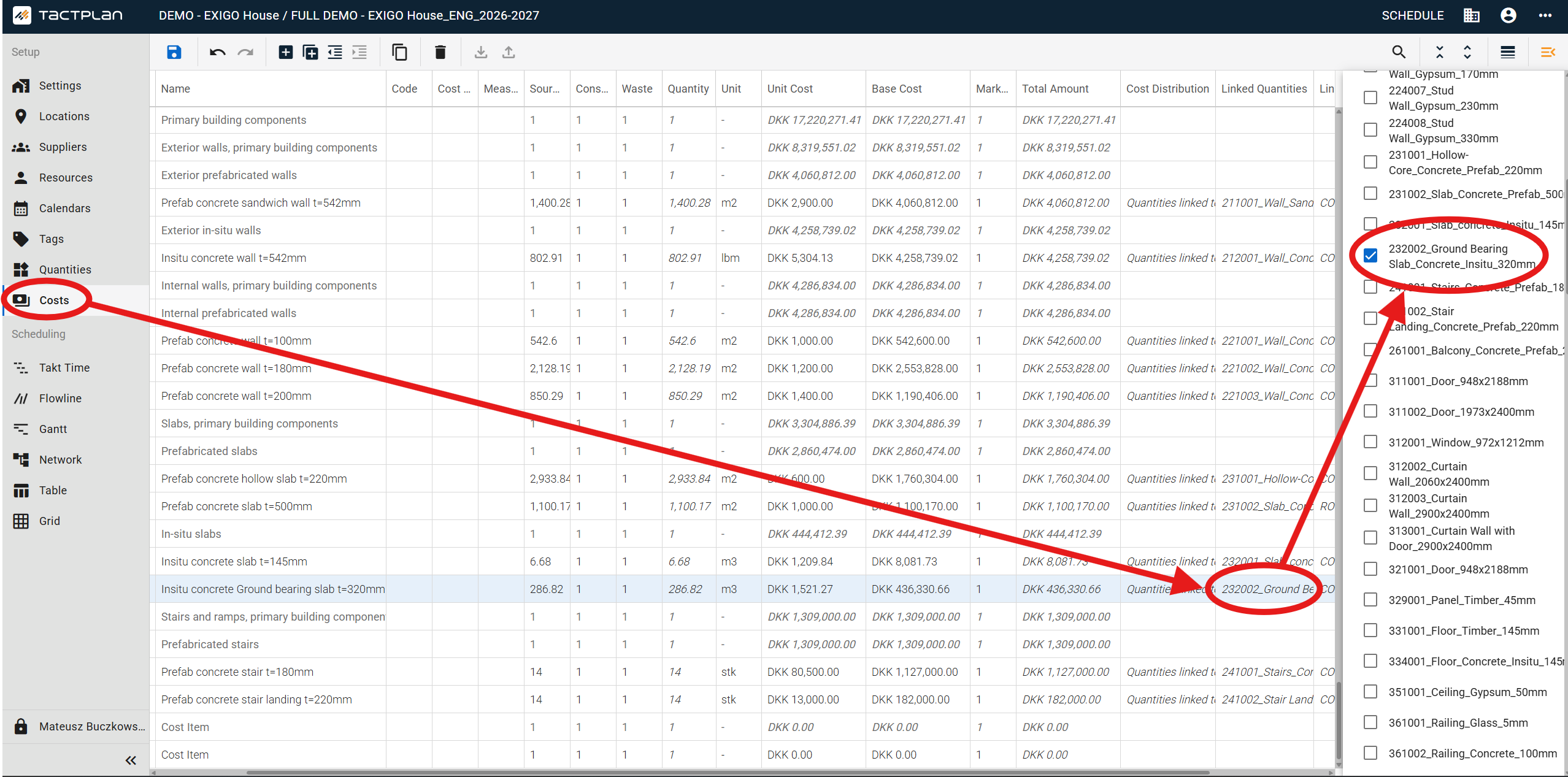

How to Link Quantities to a Cost Item
- Select one or more cost items by holding Ctrl and clicking each item.
- Open the Cost details panel by double-clicking a cell in the Linked Quantities column, or by clicking the Cost details icon in the toolbar.
- Use the search field to filter the quantities list. You can enter multiple search strings.
- Check a quantity in the panel to link it to the selected cost items. The Source Quantity value updates automatically.
- Uncheck a quantity to unlink it. The Source Quantity value is kept and becomes directly editable again.
Note: If no cost items are selected, the checkboxes in the panel are disabled.

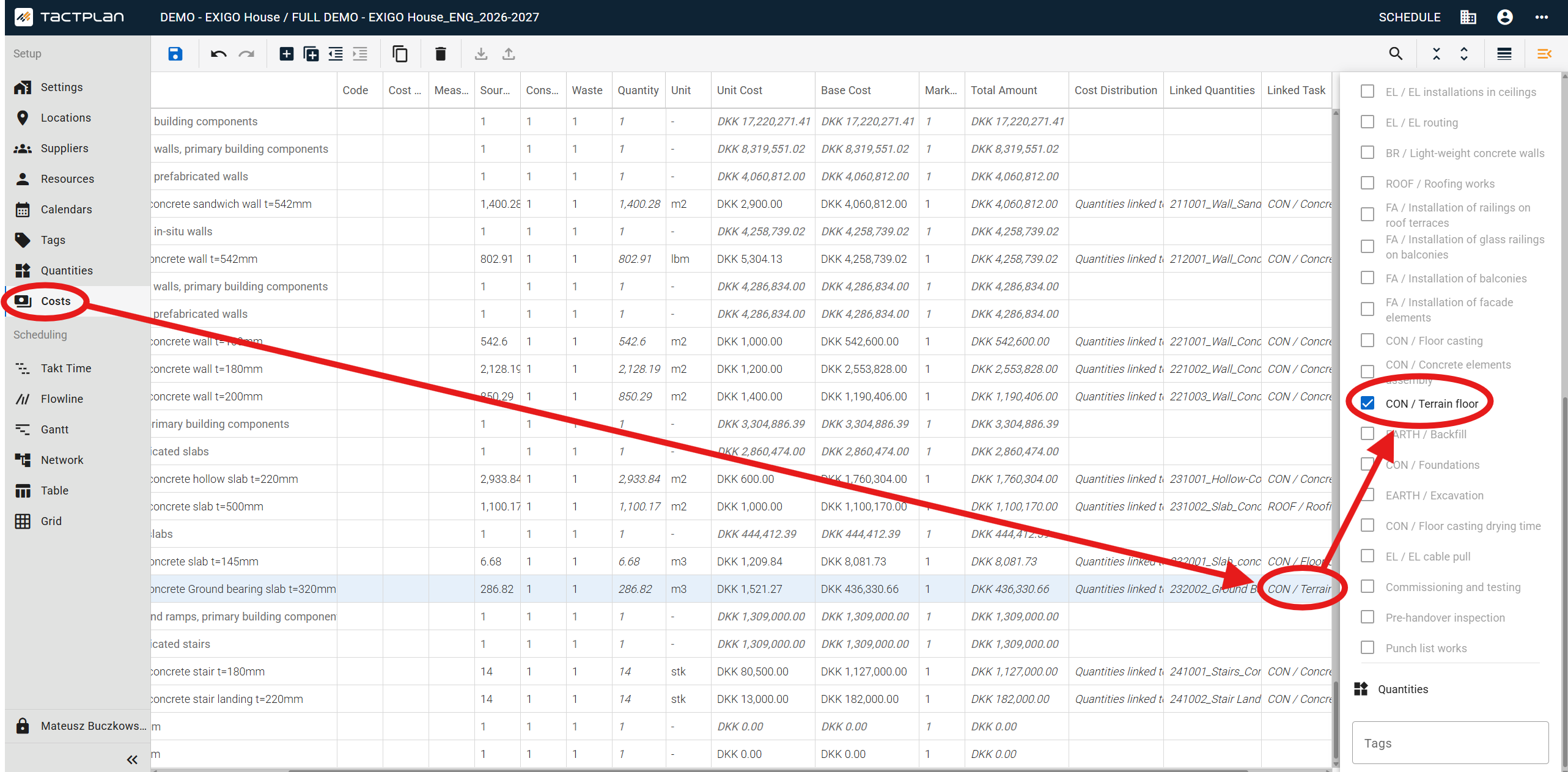

How to Link Tasks to a Cost Item
- Select one or more cost items by holding Ctrl and clicking each item.
- Open the Cost details panel by double-clicking a cell in the Linked Tasks column, or by clicking the icon in the toolbar.
- Use the search field to filter the task list. You can enter multiple search strings.
- Check a task in the panel to link it to the selected cost items.
- Uncheck a task to unlink it. The cost distribution on the task updates automatically.
Note: If a cost item has a linked quantity at a higher location precision than the task, the task will appear grayed out and cannot be linked. Move the quantity to a matching location precision to enable the link.
How to Link Tags to a Cost Item
- Select one or more cost items by holding Ctrl and clicking each item.
- Open the Cost details panel by double-clicking a cell in the Linked Tasks column, or by clicking the icon in the toolbar.
- Add a new tag or select an existing tag from the tags panel. The tag is linked to all selected cost items.
Note: Tags cannot be added when no cost items are selected.
